References

References from live operation.

Evidence instead of assertion: the figures below come from the ongoing operation of one specific site.

EMS reference project

Industrial and charging infrastructure project.

At one site, PV, battery storage, a heat pump and both AC and DC charging infrastructure are brought together under a shared control logic. The aim of the control system is continuous operation with prioritisation, not hard shutdown when load peaks occur.

100 kWgrid connection
1.7 MWinstalled charging capacity (32 × 22 kW AC and 4 × 180 kW DC)
723 kWhbattery storage at 1C
40integrated charging points
340 kWpPV capacity after repowering
−14 to +86 kWreal grid draw in operation, including feed-in

Example of this specific site. All values refer exclusively to this reference site and are neither a general market claim nor a commitment for other projects. The ratio of roughly 1:17 between installed charging capacity and grid connection is a site-specific reference. Technical feasibility, device compatibility and achievable values are assessed individually in every project.

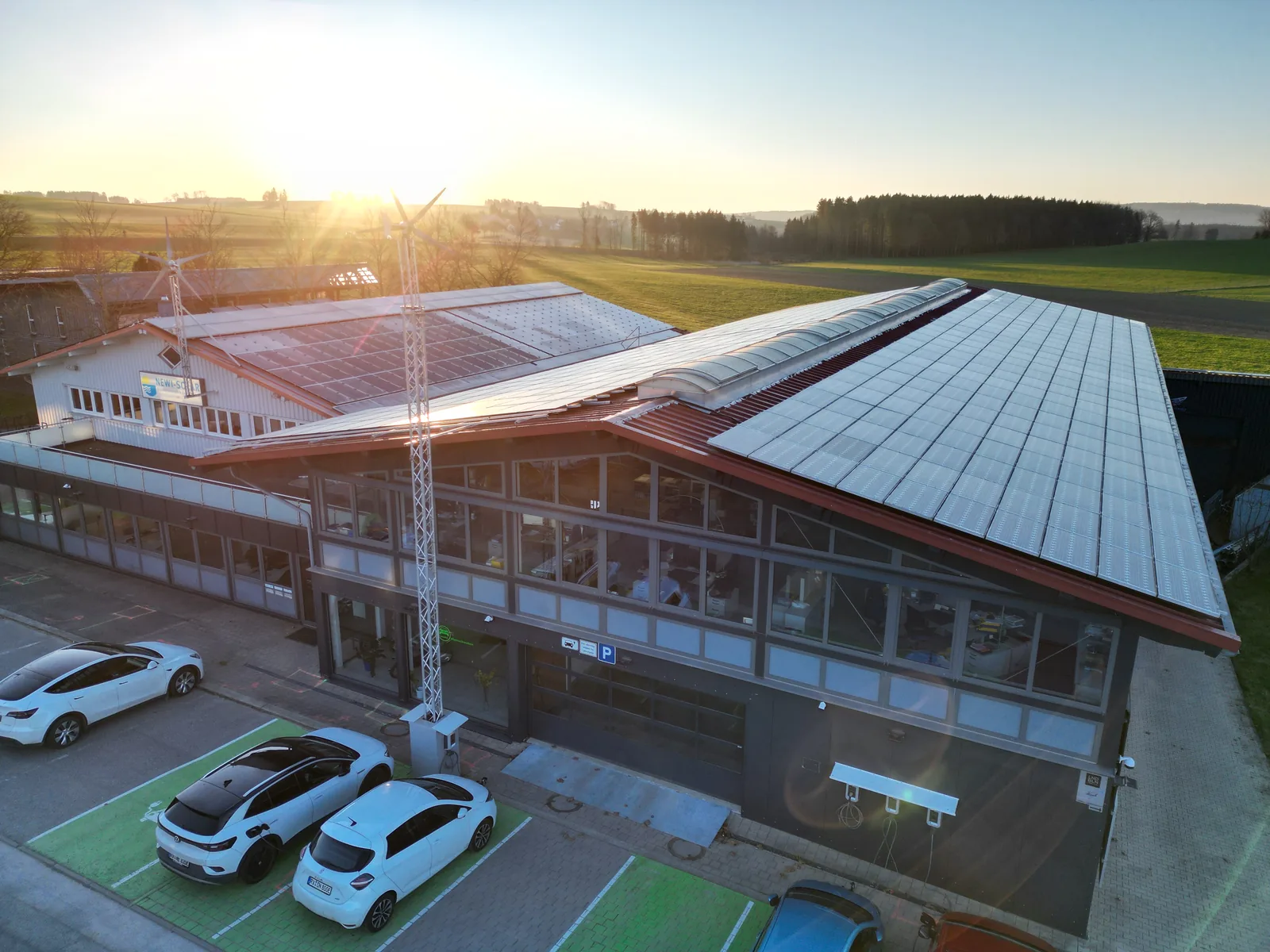

Aerial view of the reference site: commercial building with rooftop PV system and DC charging infrastructure
Starting point and system

A limited grid connection – answered with one control logic.

The site has 100 kW of grid connection capacity. The planned charging infrastructure exceeds this many times over. Reinforcing the connection was not the route chosen.

Instead, PV, battery storage, a heat pump and both AC and DC charging infrastructure were brought together under one shared control logic. The 1C storage absorbs load changes within a very short time, and grid-side power is actively limited to the available connection capacity.

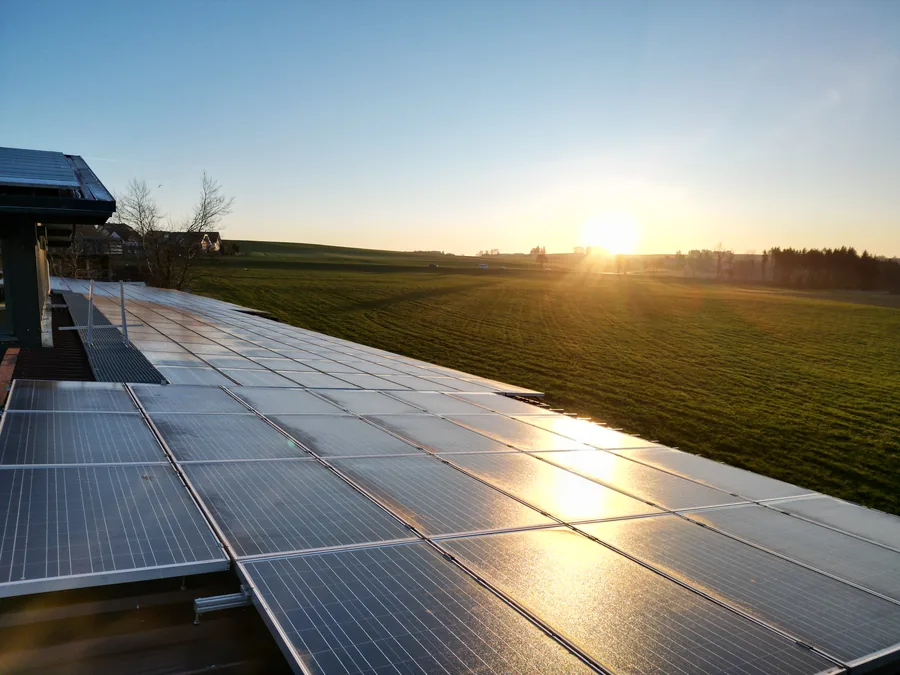

PV modules at the reference site in the morning sun

DC fast-charging station at the reference site DC charging infrastructure

AC wallboxes at the NEWOLUTION reference site AC charging infrastructure
Result

Operation instead of shutdown.

Real operating data shows grid draw and feed-in between −14 kW and +86 kW while several DC charging points were charging in parallel. The charging infrastructure with 40 points in total – 32 × 22 kW AC and 4 × 180 kW DC – continues operating without the grid connection being exceeded.

Operation and analysis run through a dedicated web GUI with in-depth technical analysis.

Reference site with 340 kWp PV, 723 kWh battery storage and 40 integrated charging points. Images: NEWOLUTION GmbH.

PV software

Use cases from the software business.

The photovoltaic software has been on the market as an online PV calculator since 2016 and is used by installers, sales organisations and energy service providers.

01

Digital entry point on the provider’s website

The PV check is embedded in the provider’s website. Prospects draw their own roof and receive an initial assessment; the sales team gets structured data instead of an empty contact form.

02

Consistent quotation process across locations

Teams at different sites work from a shared data basis, which keeps quotation quality and calculation assumptions comparable.

03

White-label deployment

The solution runs in the visual identity of the respective provider, embedded in their existing website and processes.

In use at these companies

  • BAUHAUS logo
  • Febesol logo
  • SüdEnergie logo
  • Unterholzner logo
  • Raisol logo
  • ZEKK logo
  • NE Service logo
  • LEZ Energie logo
  • Energiebündnis logo
  • Klimainitiative Heidenheim logo
  • Landkreis Heidenheim logo
  • Elevion Green logo
  • McCormick logo
  • Stumbaum logo
Qualitative results

What changes in operation.

Deliberately without percentages or savings promises. We will add quantitative figures once they are properly defined and evidenced.

Grid limit actively maintained

Grid-side power is limited to the available connection capacity and allocated by priority instead of switching loads off wholesale.

Prioritisation instead of shutdown

Critical loads such as production equipment, heat sources or defined charging points keep priority without exceeding the grid limit.

Operational management on our own infrastructure

The supervisory control layer does not depend on hardware manufacturers' remote access.

Traceable events

Logging and monitoring make plant state and faults analysable after the fact.

Discuss a project

Your site, your constraints.

No two projects are alike. Let's assess together which parts of this reference are transferable to your situation.
